RIBA Plan of Work Stages: How They Shape Construction Projects

Every RIBA stage exists to answer a specific question at the optimal time to prevent project delays or extra costs.

RIBA Plan of Work Stages: How They Shape Every Construction Project

The RIBA Plan of Work Stages split a construction project into eight phases, 0 through 7, starting with strategic definition and going through to in-use monitoring. Skipping or rushing a stage will only push that work later, to a project stage where it will be more expensive to fix.

MEP engineers can think of the stages as set around important milestones. RIBA stages help mark when loads get calculated, when systems get coordinated, and when designs are locked for construction.

Key Takeaways

  • The RIBA Plan of Work has 8 stages (0-7), each with a defined output required for the next stage to proceed.
  • Decisions made early, such as at Stage 1 or Stage 2, are the cheapest to change and the most expensive to attempt to revise later.
  • Stage 3 (Spatial Coordination) is where clashes between MEP, structure, and architecture should surface, and not later, in Stage 5, which takes place on site.
  • h2x is built for Stages 2 through 4, concept through technical design, where load calculations, system sizing, and coordinated layouts happen.
  • h2x does not cover strategic briefing, site logistics, or post-occupancy energy monitoring. While an h2x user can take advantage of read-only views and system drawing exports, the later stages in the RIBA Plan of Work exceed its scope.

What Is the RIBA Plan of Work?

The RIBA Plan of Work is a stage-by-stage framework for structuring a building project, published by the Royal Institute of British Architects. The current 2020 version defines eight project stages, numbered 0 to 7, with a clear set of tasks and a defined information output that feeds into the next stage.

Many industry professionals use the RIBA Plan, including architects, consultants, contractors, and manufacturers. The plan offers a shared language for understanding project advancement, roles, and decision making.

Image showing a construction project floor plan with 3D plumbing model overlay following the RIBA Plan of Work Stages.

Why Is the RIBA Plan of Work Important?

Without a shared stage structure, teams might work from different assumptions about how settled a design is. For example, without the RIBA structure, an engineer might size ductwork against a floor plan the architect considers provisional. Or, a contractor might price a system that hasn’t been coordinated with structure yet. Both problems could delay a project or require costly fixes.

When teams follow the RIBA stages as intended, everyone knows what “done” looks like at each point. Achieving consensus in this way can lower project costs, reduce rework, and prevent costly on-site errors.

Following a shared structure offers the most benefit for consulting engineers and contractors, who sit between an architect’s intent and a buildable, code-compliant system. They often inherit the cost of skipped or incomplete stages.

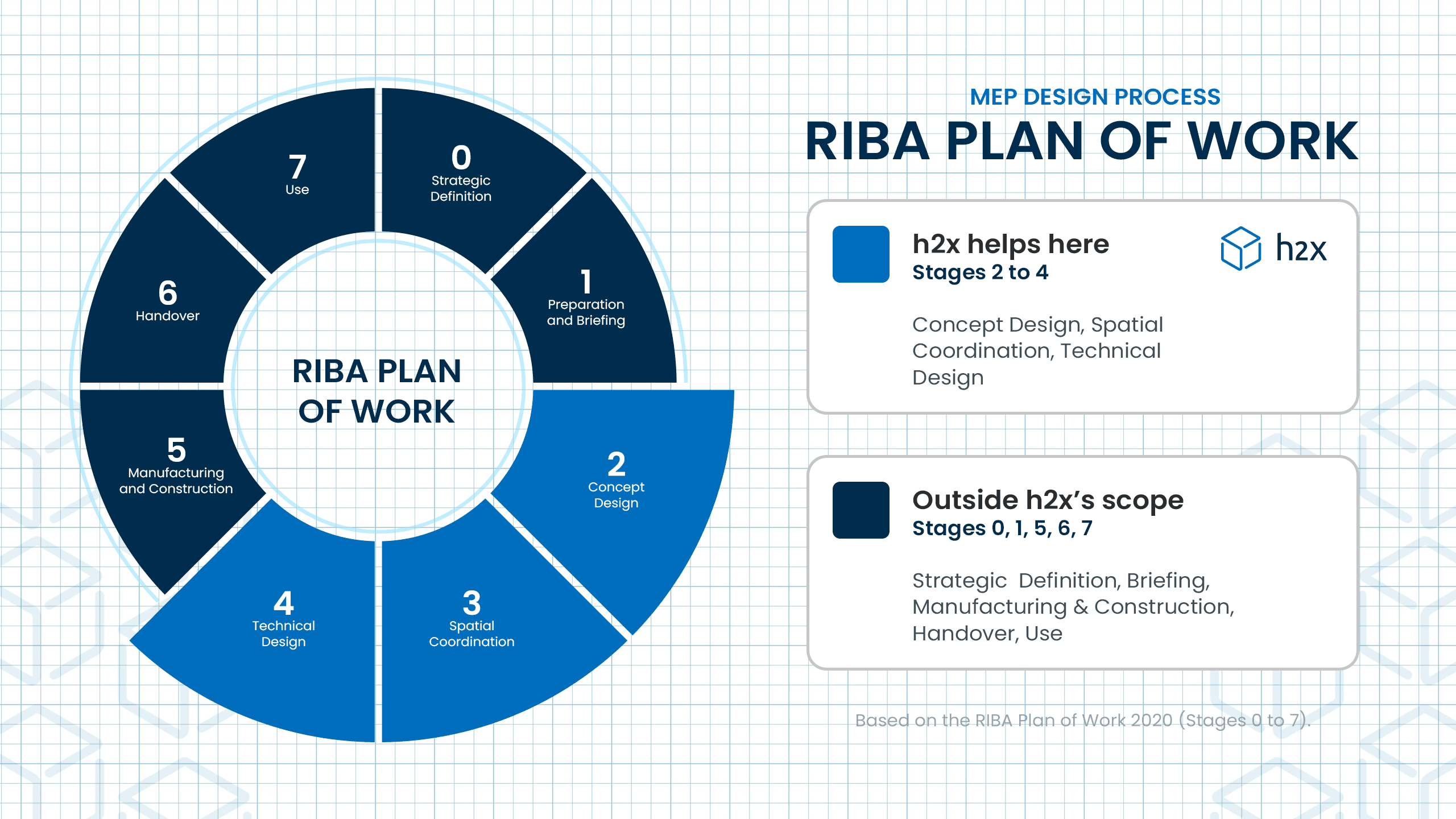

What are the Eight RIBA Plan of Work Stages?

Stage Name Key Output
Stage 0 Strategic Definition The client confirms the business case and establishes whether a new building, an extension, or a refurbishment is the right answer.
Stage 1 Preparation and Briefing The project brief, site information, and feasibility studies are pulled together, and the project team is appointed.
Stage 2 Concept Design The architectural concept takes shape, and outline structural and MEP strategies are developed alongside it.
Stage 3 Spatial Coordination Architecture, structure, and MEP are coordinated in detail. This is where high level clashes get resolved (main service runs, interacting with structural elements), before they reach the construction site.
Stage 4 Technical Design All design information needed for construction and manufacturing is completed, including detailed MEP calculations and specifications. Detailed clash detection is needed for final connection and component placement.
Stage 5 Manufacturing and Construction Components are manufactured, and the building is constructed against the technical design.
Stage 6 Handover Building services are tested and commissioned, and the building is handed over with as-built information and manuals.
Stage 7 Use The building is occupied and monitored, checking that it performs as the design intended.

RIBA Plan of Work Stages: How They Shape Every Construction Project

The RIBA Plan: Common Mistakes and Challenges

  • Skipping or truncating Stage 2. Teams sometimes skip proper outline MEP sizing at concept stage, only to discover problems in a later stage. Some examples include risers, plant rooms, or ceiling voids were not sized to fit.
  • Under-resourcing Stage 3 coordination. Spatial coordination often gets compressed to save time. This can lead to clashes between ductwork, structure, and ceilings that surface during construction instead of on a model.
  • Freezing Stage 4 too early. Locking technical design before full spatial coordination is complete can force later changes that ripple through calculations, schedules, and drawings.
  • Weak handover documentation. Rushed Stage 6 handovers leave facilities teams without clear O&M manuals or commissioning records, which can result in call-backs during Stage 7.
  • No feedback loop into Stage 7. Few projects formally check in-use performance against the Stage 0 brief. However, doing so prevents valuable lessons about system sizing from improving the next project.

Example of the RIBA Stages in Practice

On a 40-unit residential scheme in the Southeast, an MEP consultant used outline heat loss figures from Stage 2 to size a communal riser at Stage 3 spatial coordination.

The Stage 2 model was based on a fabric specification typical of the local Building Regulations Part L target. This meant U-values around 0.18 W/m²K for external walls and 0.13 W/m²K for the roof. Together, they indicated a building heat loss in the region of 180 kW across the block. That figure was enough to rule out a single 150 mm riser and confirm a twin 200 mm arrangement serving two heat pump plant rooms, one per stair core.

Because the riser was confirmed early, the architect held the shaft size through to Stage 4, even as the structural engineer revised the transfer beam design twice and the facade package changed supplier.

Notably, locking the riser dimension meant those changes could happen around a fixed void rather than forcing a fresh clash detection pass every time. As a result, this approach helped avoid a redesign that would typically take two to three weeks on a project this size, including renegotiating shaft space with structure and fire strategy.

At Stage 4, the same load calculations were refined room by room into final pipe sizing and a bill of materials covering roughly 1,400 m of pipework and associated valves and manifolds. Because the underlying model carried through rather than being rebuilt from scratch, contractors at tender could work from validated schedules instead of re-deriving loads themselves. This cut the estimating time they needed by roughly a third.

RIBA Stages: Best Practices and Tips

  • Size systems early, even roughly. Outline heat loss and load figures at Stage 2 to prevent oversizing risers, plant rooms, or duct routes. Oversized systems can disrupt Stage 3.
  • Cover clash resolution in Stage 3 and Stage 4, before you’re on site. Coordinate MEP against structure and architecture before technical design locks.
  • Keep calculations traceable across stages. Carry the same assumptions and figures from concept through technical design so nothing gets re-derived (or contradicted) later.
  • Document as you go. Build O&M and commissioning records progressively through Stages 4 to 6 instead of compiling them under deadline pressure at Stage 6.
  • Close the loop at Stage 7. Where possible, check actual building performance against the design brief. This helps sharpen approaches on the next project.

How h2x Design Software Can Help

H2x offers strong support for Stages 2 through 4, concept design through technical design, where MEP consultants need calculations and layouts.

At Stage 2, h2x’s heat load and heat loss calculations give an outline sizing basis fast enough to inform architectural decisions on riser and plant space before they’re locked in.

At Stage 3, updating a background as architectural plans change and re-running calculations in seconds helps pipe and duct system layouts stay coordinated with structure and architecture as the design settles. This benefit also carries over into Stage 4 if any detailed connection changes need to occur.

At Stage 4, h2x’s CIBSE-verified system sizing calculations, branded PDF drawing sets, bill of materials, and Revit and AutoCAD exports produce the coordinated, construction-ready technical design package this stage requires.

h2x doesn’t run Stage 0 to 1 feasibility or briefing work, manage Stage 5 site logistics or construction programming, or handle Stage 6 commissioning workflows and Stage 7 in-use energy monitoring. If your project needs support at those stages, pair h2x with tools built specifically for them.

Michael Ainscough, Senior Technical Engineer at h2x, demonstrates how a water system design project in h2x maps onto the RIBA Plan of Work, with emphasis on stages 2-4.

Conclusion

The RIBA Plan of Work only works if each stage actually delivers what the next one depends on. For MEP consultants, that means getting sizing right early and keeping it coordinated through technical design, not catching problems on site.

Frequently Asked Questions

Is the RIBA Plan of Work only used in the UK?

The RIBA Plan of Work originates in the UK, but many international consultants and contractors reference or adapt it. This is frequently the case on international projects with UK-based design teams. It can sit alongside other national frameworks as well.

What’s the difference between Stage 2 and Stage 4 for MEP design?

Stage 2 produces an outline MEP strategy: indicative system types, rough sizing, and space requirements. Later, Stage 4 produces the detailed technical design, including final calculations, sizing, specifications, and drawings ready for construction.

Can stages overlap or run out of order?

In practice, yes. The 2020 version explicitly allows overlapping stages where it suits the project. This is particularly true between Stage 3 and Stage 4. However, even in an overlap scenario, the key output of each stage still needs to be reached before the next stage.

Who is responsible for each RIBA stage?

Typically, responsibility shifts by stage. Architects typically lead Stages 0 to 2, and the full design team (including MEP consultants) drives Stages 3 and 4. Later, contractors take the lead through Stage 5, with the design team supporting handover at Stage 6.



Ready to carry domestic water sizing cleanly from Stage 2 through Stage 4?

See how h2x handles heat loss calculations, riser sizing, and coordinated layouts without re-deriving loads at every handoff.

Visit our Domestic Water Design features page



Meet the author

Michael Ainscough

Michael Ainscough is a Technical Engineer at h2x.

Linkedin   |   View all posts by Michael

Article Last Updated: September 1, 2026

Table of Contents

Loved by Engineers

★ ★ ★ ★ ★

Brilliant, simple and easy to use. Game changer.

James Major

Director at Hubb

★ ★ ★ ★ ★

h2x is great software, our company use it nearly every day. It is easy to use with direct conversion from h2x to Revit.

Callum Craig

Engineer at WDE

★ ★ ★ ★ ★

A game changer for the humble plumber. Incredible.

Brad Winkel

Director at Queenstown Plumbing

★ ★ ★ ★ ★

h2x is fantastic software. It is very easy to use and the ability to output to Revit is a fantastic time saver.

Joe Kirrane

Engineer at MEP

★ ★ ★ ★ ★

Big time game changer to the industry!

Viv Jude

Director at UHC

★ ★ ★ ★ ★

Incredible software! Super user-friendly and allows you to save so much time.

Devni Gamage

Engineer at DMA

★ ★ ★ ★ ★

The software is very easy to use. The heat load calculation function is particularly impressive.

Toinpre Amaegbe

Senior Mechanical Engineer at ROCMEP

★ ★ ★ ★ ★

We've been using h2x for our mechanical design work and are consistently impressed. Highly recommended.

Edward Jones

Mechanical Engineer at Noquet Building Services

★ ★ ★ ★ ★

The software is fantastic, it's a real time saver and we can install with confidence knowing we have all our maths correct.

Matt Little

Heating Manager at ECO Providers

★ ★ ★ ★ ★

h2x go above and beyond to ensure customer satisfaction. They are flexible, responsive, supportive, and collaborative.

Joshua Musgrove

Director at Eco-Nexus Engineering

★ ★ ★ ★ ★

Wins us more, better jobs. Accurately models complex systems in an easy to use interface. Outstanding customer service.

Nick McPhee

Director at Duo Heating & Renewables

★ ★ ★ ★ ★

Fantastic software, great results and very user-friendly producing great designs and reports.

Timothy Rudd

Director at TJR Heating & Cooling

★ ★ ★ ★ ★

I started using h2x recently and I am amazed how easy it is to produce perfect results every time.

Gary Law

Technical Consultant at EDF Heat Pumps
